Migration planning

ITSM Migration Checklist: 40 Checks from Scope to Hypercare

The only ITSM migration checklist you need: 40 checks, six phases, done tests, owners and gates, from a team with 1,000+ migrations done.

Ayush BothraFounding Member, MigrateX

Published Updated 18 min read

ITSM migration checklist with 40 checks across six phases, from scoping and mapping to cutover, reconciliation and hypercare
On this page

This ITSM migration checklist is for moving an IT service desk to a new platform: incidents, service requests, problems, changes, knowledge articles and CIs, with the links between them. It has 40 checks in six phases. Each check says what "done" looks like, who owns it, and what to watch for, and every phase ends with a go/no-go gate.

It is the working companion to our ITSM migration plan. Read the plan for the reasoning: what moves, what gets rebuilt, and the platform limits that shape the project. Then come back here and work through the checks in order.

Forty checks is a lot, and a few will look like overkill for your desk. They are on the list because each one has, at some point, been the reason a migration slipped, a requester saw an internal note, or an auditor could not find a ticket. The list comes from the 1,000+ migrations our team has done for companies worldwide, so treat every check as there for a reason. If one genuinely does not apply to you, drop it in writing at gate 1, not on cutover weekend.

A generic data migration checklist, or an IT migration checklist written for servers and mailboxes, copies rows. A service desk is harder than rows. Records link to each other, SLA results are computed from their history, notes are public or internal, attachments live in a separate store, and the desk keeps taking tickets until the moment you switch. Workflows, automations, business rules, SLA definitions, macros and running SLA timers are rebuilt on the target, not migrated. This checklist is built around those differences.

The six phases at a glance

Checks 1 to 22 are the pre-migration checklist: everything that has to be true before any production data moves. The phases match the six-phase plan in our migration guide, so the two documents can be read side by side. Checks 23 to 29 are cutover. Checks 30 to 40 are the post-migration checklist: proof, sign-off and hypercare.

PhaseChecksGate ownerStage
1. Scope and inventory1 to 8Migration lead and audit ownerPre-migration
2. Map9 to 16Process ownersPre-migration
3. Test migration17 to 22Migration leadPre-migration
4. Cutover and delta sync23 to 29Service ownerCutover
5. Reconcile and sign-off30 to 35Process owners and audit ownerPost-migration
6. Hypercare36 to 40Service ownerPost-migration

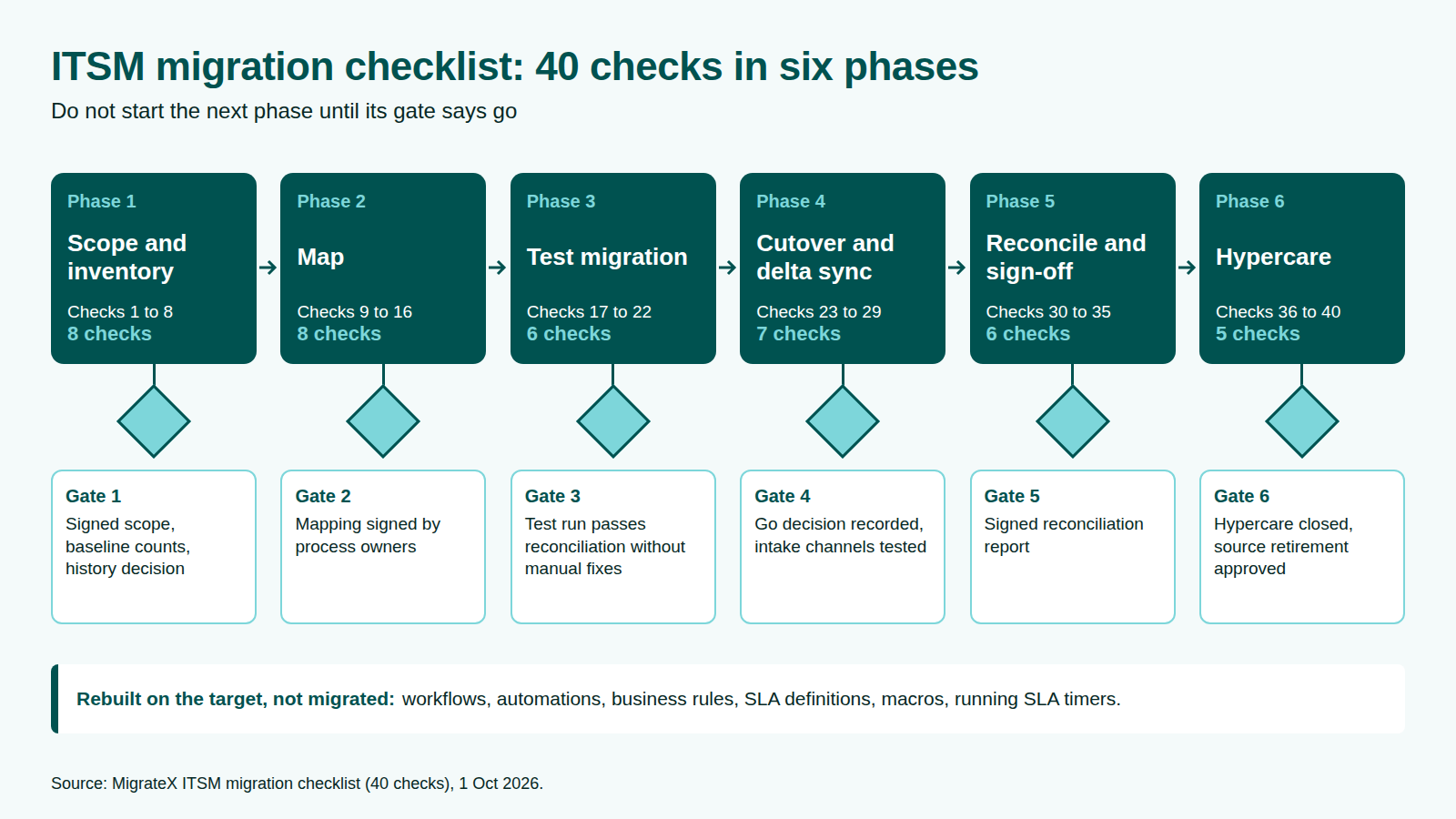

Migration checklist for an ITSM service desk: six phases with 40 checks and a go/no-go gate after each phase

Phase 1: scope and inventory (checks 1 to 8)

Scoping decides what moves, what is archived and what is rebuilt. Most migrations that go wrong go wrong here, because nobody wrote down what "everything" meant. If a vendor date is driving you, pin it first: Atlassian Data Center products, Jira Service Management included, become read-only on 28 March 2029 (Atlassian, as of 23 Oct 2026); our Jira Data Center end-of-life timeline and Cherwell end-of-life guide have the dates for the other common triggers.

  1. Name a migration lead. Done: one named lead owns every gate, and the sign-off owners for audit, reporting and each process are named in writing. Why: a migration with three part-owners has none. Each gate below needs a person who can say no. See why every enterprise migration needs a project lead.
  2. Confirm the trigger date. Done: the vendor has confirmed in writing when your source loses support, goes read-only, or when your contract ends. Why: the trigger date sets the freeze window, and the freeze window sets everything else. Watch out: "end of sale" and "end of support" are different dates, and renewal notice periods often sit 60 to 90 days before the contract end.
  3. Fix the scope. Done: a signed scope names source, target and every record type that moves, from incidents and service requests to problems, changes, knowledge articles, CIs, CI relationships, attachments, public replies and internal notes. Why: anything not on this list will be assumed out of scope by somebody. Watch out: ask for the same written scope in every vendor quote, so prices compare. Our data migration RFP template and help desk migration cost guide show what to put in it.
  4. Record baseline counts. Done: dated counts per record type and per state exist, taken from the source on a stated day, and stored where reconciliation (check 30) can find them. Why: reconciliation is counts on the target versus counts on the source plus the delta. Without a dated baseline there is nothing to reconcile against. Watch out: count per state, not just in total. A total can match while closed tickets are missing and open ones are duplicated.
  5. Audit the source data. Done: duplicates, orphaned records, test tickets, unused fields and dead groups are tagged keep, fix or drop, with an owner for each decision. Why: every bad record you move becomes a bad record you now own on the new platform, and a mapping exception you have to maintain. Our Zendesk export guide shows how to decide what to delete, keep or leave behind.
  6. Decide how much history moves. Done: full history, active work only, or archive plus selective migration is chosen in writing with the audit and reporting owners. Why: this decision sets the record volume, the export method, the test runs and the price. itsm.tools, an ITSM analyst site, describes the same three options and recommends archive plus selective migration (itsm.tools, as of 1 Oct 2026). Our guide to migrating ticket history walks through the trade-offs.
  7. Record platform limits. Done: export, API and import limits for both platforms are written in one sheet, with the source page and date for each. Why: the limits decide whether full history comes out at all, and how long it takes. The platform limits table below has the ones we check first.
  8. Write the rebuild list. Done: every workflow, automation, business rule, SLA definition, macro, notification and integration is listed with an owner and a target equivalent, or marked "retire". Why: these are not data. They are rebuilt on the target as a second workstream, and the mapping in phase 2 needs them to exist. Watch out: Atlassian's Jira Cloud Migration Assistant carries SLAs, workflows, queues and request types from Data Center to Cloud (Atlassian, as of 23 Oct 2026); between vendors, nothing does.

Gate 1: signed scope, dated baseline counts, a written history decision and a rebuild list with owners.

Phase 2: map (checks 9 to 16)

Mapping gives every source value a documented home on the target. The output is a set of mapping sheets, one per record type, signed by the process owner who will live with the result. For platform-specific load order, see our ServiceNow migration guide; for one worked pair, the ServiceNow to Jira migration guide.

  1. Build the target first. Done: workflows, statuses, request types, groups and SLA definitions exist on a test target before any mapping sheet is signed. Why: a mapping sheet needs targets to point at. Jira's CSV import can only map to statuses that already exist in the target workflow (Atlassian, as of 23 Oct 2026). Freshservice's Bulk API requires workspaces and users to exist before tickets load (Freshservice support, modified 24 Nov 2025).
  2. Map every state. Done: every source state, including rare, retired and custom ones, has exactly one target state, and the sheet shows the count of records in each. Why: an unmapped state either fails the load or lands as the default state, which usually means closed tickets reopen. Watch out: Freshservice's API uses status codes 2 Open, 3 Pending, 4 Resolved and 5 Closed (Freshservice API docs, as of 23 Oct 2026); map to the code, not the label.
  3. Map priority as impact and urgency. Done: the source priority matrix is mapped to the target matrix, not number to number, and a sample of mapped priorities has been checked by the process owner. Why: priority numbers run in opposite directions between platforms. In ServiceNow, 1 is Critical; in the Freshservice API, 1 is Low (ServiceNow docs; Freshservice API docs, as of 23 Oct 2026). Map by number and every critical incident becomes a low one.
  4. Map users, groups and leavers. Done: users and groups load before tickets, every assignee and requester resolves to a target user, and leavers have an agreed form (a deactivated user, a placeholder, or the group). Why: a ticket whose requester does not exist on the target either fails or loses its requester. Watch out: licence counts. Loading every historical agent as an active user can trigger seat charges on the target.
  5. Keep note visibility. Done: public replies and internal notes each have a load path that preserves their visibility, and the path has been checked on one ticket of each kind. Why: in Jira Service Management, comments imported by CSV become public (Atlassian, as of 23 Oct 2026). Freshservice separates private notes from public replies (Freshservice support). Get this wrong and requesters read agent-only notes on the portal.
  6. Plan CIs and relationships. Done: CI classes are mapped, and the load order is written as CIs, then relationships, then task-to-CI links. Why: a relationship is a record that points at two CIs, and a task-to-CI link points at a task and a CI. Load them before the things they point at and they fail or land as text. Our ServiceNow CMDB guide covers identification rules and why duplicates appear.
  7. Store the source ID. Done: every target record carries its source ID in a field, and an old-to-new ID cross-reference table exists. Why: ServiceNow's sys_ fields are system generated and generally cannot be set (ServiceNow Table API docs, as of 23 Oct 2026), so expect new IDs on the target. The cross-reference is how you remap links (check 32), re-run loads (check 18) and answer "where did ticket 48213 go?" a year later.
  8. Decide SLA history. Done: historic SLA results are kept as fields on each record, as an archive, or both, and open tickets with running timers have a written cutover rule. Why: targets recalculate SLAs from their own clocks. ServiceNow's SLA repair "removes the SLA record, then recreates and recalculates it" (ServiceNow SLA repair docs, as of 23 Oct 2026). Jira Service Management calculates SLAs from issue history, so imported issues get a clock that starts at import (Atlassian issue JRACLOUD-98370). Store the outcomes as data before the move.

Gate 2: mapping sheets signed off by every process owner, with record counts per mapped value.

Phase 3: test migration (checks 17 to 22)

A test migration is a full rehearsal into a non-production target, reconciled exactly as production will be. It is the only phase where a failure is cheap. Our test migration checklist lists what a test run should prove before you commit to a provider; the Zendesk to Jira migration guide shows one in practice.

  1. Load a representative set. Done: the test load covers every record type, every state, the longest threads, archived records, records with many attachments, internal notes and at least one record per mapped exception. Why: a test of 500 recent open tickets proves nothing about ten years of closed ones. Watch out: pick the sample from the baseline counts (check 4) so every state with records is represented.
  2. Make the load re-runnable. Done: a second run of the same load updates records instead of duplicating them, and the count after run two equals the count after run one. Why: the delta sync at cutover (check 26) is a re-run, so if re-runs duplicate, cutover duplicates. In ServiceNow, a coalesce match updates and no match inserts; without a coalesce field, every row inserts as new, and if several records match, only the first is updated (ServiceNow import set coalesce docs, as of 4 Nov 2026). Coalesce on the source ID from check 15.
  3. Check references. Done: no requester, assignee, group, CI or parent record landed as plain text, and a query for "reference fields that do not resolve" returns zero. Why: a reference that fails to resolve often does not error. In ServiceNow, request both values with sysparm_display_value=all so each reference keeps its ID and its name (ServiceNow Table API docs, as of 27 Oct 2026), then check both arrived.
  4. Check notes as a requester. Done: signed in as a customer on the portal, you can see your public replies and no internal note, on a ticket with both. Why: this is the only test that catches a visibility mapping error before a requester does. Do it as a real requester account, not as an admin impersonating one.
  5. Check SLAs on imported records. Done: no historic closed record shows a breach, and no imported open record has a wrong clock. Why: see check 16. Atlassian's own tracker describes imported issues breaching because the SLA sees only an "Issue Created" event (JRACLOUD-98370); the usual fixes are excluding imported issues through a custom field or bulk transitioning them to done. Watch out: pause target automations during the test load, or every imported record fires a notification.
  6. Time the rehearsal. Done: the full run is timed end to end, including attachments, and the freeze window (check 24) is sized from that number plus the delta. Why: the rate limits decide the clock. Freshservice's Bulk API takes 50 tickets or notes per request at 10 requests per minute per endpoint, with limits marked "To be confirmed post load testing", and a partner migration token raises the public API limit to 700 calls per minute for an agreed window (Freshservice support, modified 24 Nov 2025; migration process article, modified 21 Mar 2025). For Jira Cloud, Atlassian recommends CSV files of about 1,500 work items, at roughly an hour each (Atlassian, as of 23 Oct 2026). See how to import tickets into Freshservice and how long data migration takes.

Gate 3: a test run that passes reconciliation (checks 30 to 34) without manual fixes, with the run timed.

Phase 4: cutover and delta sync (checks 23 to 29)

Cutover loads history early, freezes the source briefly, then picks up what changed. The freeze is short only because the bulk went first. Our Cherwell to ServiceNow migration guide runs this against a vendor deadline.

  1. Load the bulk early. Done: historical records are loaded to production and reconciled against the baseline before the freeze window opens, and the bulk cut-off timestamp is recorded. Why: a freeze window that includes the bulk load is days long. One that includes only the delta is hours.
  2. Book the freeze window. Done: the window is approved as a change, sized from check 22, and agents, requesters and integration owners have been told the start, the end and what to do with new requests during it. Why: an unannounced freeze turns into tickets raised by phone and email that never reach either system.
  3. Freeze the source. Done: changes on the source have stopped, intake is paused or queued, and the freeze timestamp is recorded as the delta cut-off. Why: every record created or changed after this timestamp is the delta. Record it to the second, in one time zone, in the change record.
  4. Run the delta sync. Done: every record created or changed between the bulk cut-off and the freeze timestamp is on the target, and the delta counts match per record type. Why: this is the re-run from check 18, run for real. Watch out: Freshservice's Bulk API errors "cannot be retried automatically" (Freshservice support, modified 24 Nov 2025), so the delta needs its own failure log and a manual retry path.
  5. Load attachments as their own workstream. Done: attachment counts per record match, failures are logged with the record ID and the reason, and the largest files have been opened on the target. Why: attachments fail for different reasons from records: size, type, and the way the target accepts them. Freshservice's Bulk API takes attachments as public URLs and allows 40 MB per entity, and rejects an attachment over the limit while still creating the ticket (Freshservice support, modified 24 Nov 2025). ServiceNow's Attachment API takes one file per request, up to a 1,024 MB default maximum (ServiceNow Attachment API docs, as of 23 Oct 2026). See preventing the lost attachment flood at cutover.
  6. Hold the go/no-go. Done: the named criteria are checked one by one, the decision and the decision-maker are recorded in the change, and the rollback point is written down with who can trigger it. Why: the decision that matters is whether intake switches. Make it against criteria agreed in phase 1, not on the mood of the room at 2am.
  7. Switch intake. Done: email, portal, phone, chat and every integration point at the target, and a test ticket from each channel has landed on the target and been assigned. Why: a channel still pointing at the source after go-live creates tickets nobody is watching. Watch out: integrations that write into the service desk (monitoring, HR, CRM) are the ones most often forgotten.

Gate 4: go decision recorded, delta counts matched, and every intake channel tested on the target.

Phase 5: reconcile and sign-off (checks 30 to 35)

Reconciliation proves, record by record, that what arrived matches what left. It is the post-migration checklist your auditors will ask about. Our help desk migration risks guide lists what goes wrong when this phase is skipped.

  1. Compare counts. Done: counts per record type and per state on the target equal the baseline plus the delta, or every gap has a written explanation. Why: this is the headline number for sign-off, and it is only meaningful because of checks 4 and 25.
  2. Sample records end to end. Done: a sample per record type, drawn from every state, matches the source on field values, note order, note visibility, note authors, timestamps and attachments. Why: counts prove volume. Samples prove fidelity. Watch out: include the oldest records and the longest threads, because those are where exports truncate. Freshservice's REST API, for example, returns at most ten conversations per ticket inline; longer threads need a separate call (Freshservice API docs, as of 26 Oct 2026).
  3. Open the links. Done: a sample of incident-to-problem, incident-to-change, change-to-CI and parent-to-child links opens as real links on the target, not as text in a field. Why: the links are what make the history useful. They are also the first thing a generic data migration drops.
  4. Check knowledge. Done: a sample of articles renders with their formatting, images and attachments, and article-to-ticket links resolve. Why: knowledge articles carry embedded images and internal links that break quietly.
  5. Close the discrepancy log. Done: every difference found in checks 30 to 33 has a cause and a fix, or a signed acceptance from the process owner. Why: an open discrepancy at sign-off becomes a hypercare ticket with no owner.
  6. Sign off. Done: process owners and the audit owner have signed the reconciliation report, which lists the baseline, the delta, the target counts, the samples and the closed discrepancy log. Why: this report is the evidence that the migration happened as scoped. Keep it with the archive.

Gate 5: signed reconciliation report.

Phase 6: hypercare (checks 36 to 40)

Hypercare is the period after go-live when the migration team stays on call and fixes problems at their cause, not one ticket at a time.

  1. Staff hypercare. Done: named contacts are on call with hours published to the desk, and a queue or tag exists for migration-related issues so they can be counted. Why: without a tag, migration issues disappear into the normal queue and nobody sees the pattern.
  2. Watch SLAs and routing. Done: new SLA breaches, wrong assignment groups and priority mismatches on migrated records are reviewed daily for the first weeks and traced to the mapping sheet. Why: a mapping error shows up as a pattern, not a single ticket. Fix the mapping and bulk-correct, rather than correcting tickets by hand.
  3. Trace missing-data reports. Done: each missing attachment, broken link or missing note reported by an agent is traced to its cause in the load log and fixed in bulk across every affected record. Why: one report is usually the first of many.
  4. Keep the source read-only. Done: audit and reporting owners can still open old records on the source, or in the archive chosen in check 6, until they confirm in writing that they have what they need. Why: the day you switch the source off is the day someone asks for a ticket from 2019.
  5. Retire the source. Done: the exit criteria from phase 1 are met, retirement is approved as a change, the archive location is recorded, and the source contract is closed. Why: the migration is not finished while you are paying for two platforms.

Gate 6: hypercare closed and source retirement approved.

Platform limits to record before you map (check 7)

These are the limits we check first on the three platforms we see most. Record your own in the same format, with the source page and the date, because vendors change them.

PlatformLimitWhat it means for the planSource
ServiceNowList exports (CSV, XML, Excel, JSON) default to 10,000 recordsFull history comes out through the Table API, not the list exportServiceNow export limits docs, as of 23 Oct 2026
ServiceNowTable API sysparm_limit defaults to 10,000; page with sysparm_offset; sysparm_display_value=all returns IDs and display valuesPaginate every table, and request both values so references surviveServiceNow Table API docs, as of 27 Oct 2026
ServiceNowAttachment API: one file per request, 1,024 MB default maximumAttachments are a separate, slower workstreamServiceNow Attachment API docs, as of 23 Oct 2026
FreshserviceStandard export caps at 10,000 tickets and excludes conversations and internal notesNotes and long history come out through the APIFreshservice exporting tickets article, modified 13 Jun 2026
FreshservicePublic API rate limits of 100 to 500 calls per minute by plan, shared by every integration; at most 100 records per pageSize the run time from the plan's limit, and pause integrations during the loadFreshservice API docs, as of 26 Oct 2026
FreshserviceBulk API: tickets and notes only, 50 per request, 10 requests per minute per endpoint, 40 MB of attachments per entity, errors not retried automaticallyEverything else loads through the public API; build a retry logFreshservice Bulk API article, modified 24 Nov 2025
Jira Service Management CloudCSV import maps only to existing statuses; about 1,500 work items per file recommended, roughly an hour each; imported comments become publicBuild the workflow first, plan for many files, and load internal notes another wayJira CSV import docs, as of 23 Oct 2026
Jira Service Management CloudSLAs are calculated from issue history, so imported issues start a new clockStore historic SLA outcomes as fields; exclude imported issues from live SLAsAtlassian issue JRACLOUD-98370

For Zendesk sources, our Zendesk to Freshservice migration guide covers the export side.

Summary table: the 40-check migration checklist template

Copy this table into your tracker. Fill in the owner column with names, not roles, before gate 1.

#PhaseCheckOwnerEvidence of done
1ScopeLead namedSponsorOwners in writing
2ScopeTrigger dateMigration leadVendor confirmation
3ScopeScope fixedMigration leadSigned scope
4ScopeBaseline countsSource adminDated counts per state
5ScopeData auditedProcess ownersKeep/fix/drop list
6ScopeHistory decisionAudit ownerWritten decision
7ScopeLimits recordedPlatform adminsLimits sheet with sources
8ScopeRebuild listTarget adminList with owners
9MapTarget builtTarget adminConfigured test target
10MapStatesProcess ownersSigned state map with counts
11MapPriority matrixProcess ownersSigned matrix map
12MapUsers and groupsTarget adminLeaver rule
13MapNote visibilityMigration engineerLoad path per note type
14MapCIs and relationshipsCMDB ownerSigned load order
15MapSource IDMigration engineerID cross-reference
16MapSLA historyReporting ownerWritten decision
17TestRepresentative loadMigration engineerLoad log
18TestRe-runnable loadMigration engineerRerun, no duplicates
19TestReferencesMigration engineerZero unresolved references
20TestRequester viewService desk managerPortal check
21TestImported SLAsReporting ownerNo historic breaches
22TestRehearsal timedMigration leadTimed run
23CutoverBulk loadedMigration engineerBulk reconciled, cut-off recorded
24CutoverFreeze bookedService ownerApproved change
25CutoverSource frozenSource adminFreeze timestamp
26CutoverDelta syncMigration engineerDelta counts match
27CutoverAttachmentsMigration engineerCounts match, failures logged
28CutoverGo/no-goService ownerRecorded decision
29CutoverIntake switchedTarget adminTest ticket per channel
30ReconcileCountsMigration leadCount report
31ReconcileSamplesProcess ownersSample sheet
32ReconcileLinksCMDB ownerLink sample
33ReconcileKnowledgeKnowledge managerArticle sample
34ReconcileDiscrepanciesMigration leadClosed log
35ReconcileSign-offAudit ownerSigned report
36HypercareStaffedService desk managerOn-call rota and queue
37HypercareSLAs and routingService desk managerDaily review
38HypercareMissing dataMigration engineerRoot-cause log
39HypercareSource read-onlySource adminAccess list
40HypercareSource retiredService ownerRetirement approval

The evidence pack you should have at the end

If the checklist was followed, these documents exist. If one is missing, a check was skipped.

  • Signed scope and rebuild list (checks 3 and 8)
  • Dated baseline counts per record type and state (check 4)
  • Written history decision (check 6)
  • Platform limits sheet with sources (check 7)
  • Signed mapping sheets, one per record type (gate 2)
  • Test load log, timed, with the re-run result (checks 17, 18 and 22)
  • Change record with freeze timestamp, delta counts and the go/no-go decision (checks 24 to 28)
  • Attachment failure log (check 27)
  • Reconciliation report with samples and the closed discrepancy log (checks 30 to 35)
  • Retirement approval and archive location (check 40)

Ask any provider you are evaluating which of these they hand over. Our guide to ITSM data migration services explains what a specialist does differently from an implementation partner.

Want this checklist built around your migration?

You can use the checklist above exactly as it is. If you would rather have one built around your move, tell us which platforms you are switching between and what is in scope, and we will put together a checklist for your migration at no cost, along with a free 30-minute migration consultation to walk through it. Email partnerships@migratex.com with the tools involved and your exact need.

Facts checked October 27, 2026 from ServiceNow export limits docs, ServiceNow Table API docs, ServiceNow import set coalesce docs, ServiceNow SLA repair docs, Freshservice exporting tickets article, Freshservice Bulk API article, Freshservice API docs, Jira CSV import docs and Atlassian Data Center end of life. No vendor paid for this article. How we research

ITSM migration checklist FAQ

How do you migrate without losing ticket history and SLAs?

Decide in writing how much history moves (check 6). Keep every record's source ID and the links between records, so an incident still points at its problem, change and CI after the move (checks 15 and 32). Load public replies and internal notes through paths that keep their visibility (check 13). Store historic SLA outcomes as fields on each record before the move, because targets recalculate SLAs from their own clocks and imported records start a new one (checks 16 and 21). Then prove all of it with a timed test migration that passes reconciliation before any production data moves (checks 17 to 22).

What is the difference between a data migration checklist and an ITSM migration checklist?

A data migration checklist covers moving rows: extract, transform, load, validate. An ITSM migration checklist adds what a service desk depends on: incident, problem, change and CI links, SLA results computed from history, note visibility, a freeze window with delta sync, and hypercare. It also separates data, which moves, from workflows, automations and SLA definitions, which are rebuilt on the target.

What should a pre-migration checklist cover?

Checks 1 to 22 here: a named lead, a confirmed trigger date, a signed scope, dated baseline counts, a data audit, a written history decision, the platform limits, the rebuild list, mapping sheets for states, priorities, users, notes, CIs, IDs and SLAs, and a timed test migration that passes reconciliation. If any of those is missing, production data should not move yet.

What should a post-migration checklist cover?

Checks 30 to 40: counts that match baseline plus delta, end-to-end samples per record type, links that open, knowledge that renders, a closed discrepancy log, a signed reconciliation report, staffed hypercare with a migration queue, daily SLA and routing review, bulk fixes for missing-data reports, a read-only source until audit owners release it, and a recorded retirement.

What is a go/no-go gate in a migration?

A go/no-go gate is a recorded decision at the end of a phase, made by a named owner against criteria agreed in advance. If the criteria are not met, the next phase does not start. The gate that matters most sits inside cutover: after the delta sync, someone decides whether intake switches to the new platform or the desk stays on the source. Write the criteria down in phase 1, when nobody is tired.

How long does an ITSM migration take?

There is no neutral public benchmark, and we do not quote one. Duration depends on record volumes, how much history moves, how many states and fields need mapping, the export and API limits on both platforms, how many test runs it takes to pass reconciliation, and when a freeze window is free. The honest way to find out is check 22: time the rehearsal. See how long data migration takes for the factors.

Should you migrate all ticket history?

Not always. The three options are full history, active work only, or a full archive plus selective migration, and itsm.tools recommends the third (itsm.tools, as of 1 Oct 2026). Decide with your audit and reporting owners, in writing, before mapping. Whatever you choose, old tickets must stay reachable after the source retires, which is check 39.

Can I use a generic migration checklist template instead?

You can start from one, but it will miss the checks that break service desks: note visibility (13 and 20), SLA recalculation (16 and 21), re-runnable loads for delta sync (18 and 26), attachments as a separate workstream (27) and links that must open as links (32). The summary table above is a template you can copy as it is.

Written by

Ayush Bothra

Founding Member, MigrateX

Ayush writes about ITSM platforms, pricing and what it takes to move a service desk to a new platform without losing its history.
